How to Write a Construction Daily Report That Actually Gets Read
Most daily progress reports are written for compliance and read by no one. Here's a field-tested structure that turns your DPR into the single source of truth for progress, manpower, and delays.
Praful Rudra · Co-Founder & CEO
5 min read
A daily progress report is the most frequently produced document on any construction project — and usually the least useful. Written at 7 PM from memory, copied from yesterday's version, and filed into a folder nobody opens until there's a dispute.
That's a waste, because a good DPR is the cheapest risk-management tool a project has. It's contemporaneous evidence for claims, an early-warning system for slippage, and the one record that ties manpower, weather, and progress to a specific date.
A useful daily report answers four questions in under five minutes of reading: what moved, who was on site, what blocked us, and what's at risk tomorrow. Structure beats prose — capture quantities against WBS activities, log delays the day they happen, and photograph everything that gets covered up.
What a daily report is actually for
Before the structure, get the purpose straight. A DPR serves three audiences with three different needs:
| Audience | What they need from the DPR |
|---|---|
| Project manager | Progress vs. plan, blockers needing escalation |
| Client / PMC | Evidence of manpower, activity, and compliance |
| Future you (claims) | A dated, contemporaneous record of delays and instructions |
The third audience is the one most teams forget — until an extension-of-time claim depends on proving that rebar deliveries were late for eleven specific days in March.
The structure that works
1. Progress against activities, not paragraphs
The single biggest upgrade: report quantities against your work breakdown structure, not free-text descriptions. "Casting completed for columns C-14 to C-22, Zone B, 38 m³" is data. "Concreting work continued in Zone B" is noise.
- Tie every line to a WBS activity code
- Record actual quantities (m³, m², tonnes, running meters)
- Flag the delta from planned output — that's the early warning
2. Manpower and plant, counted
Record headcount by trade and by subcontractor, plus major plant hours. When a claim or dispute surfaces later, unverifiable round numbers ("approx. 120 workers") get challenged first.
3. Delays and instructions, logged same-day
The same-day rule
A delay logged the day it happens is evidence. A delay reconstructed three weeks later is an opinion. If the client's engineer issued a verbal instruction, it goes in today's report — with a name and a time.
Capture: what was delayed, cause, hours or output lost, who was notified. Weather stoppages, drawing holds, material shortages, and access restrictions all count.
4. Photos of anything that gets covered up
Waterproofing before screed. Rebar before casting. Backfill before compaction. If it disappears inside the permanent works, it needs a dated photo attached to the day's report — not sitting in someone's phone gallery.
Common mistakes that kill DPR value
- Copy-paste inheritance. Yesterday's report becomes today's template, and stale line items survive for weeks. Reviewers learn to skim, then to skip.
- Prose instead of data. Long narrative paragraphs hide the numbers that matter and can't be aggregated across days.
- The 7 PM memory exercise. Reports written after the fact miss the morning's delays. Capture as you walk, not at the desk.
- No link to the schedule. If a report can't tell you whether the project slipped today, it isn't a progress report — it's a diary.
- WhatsApp as the record. Photos and delay notes scattered across group chats are effectively lost. See our breakdown of why WhatsApp fails as a site record.
Is there a free tool for writing one?

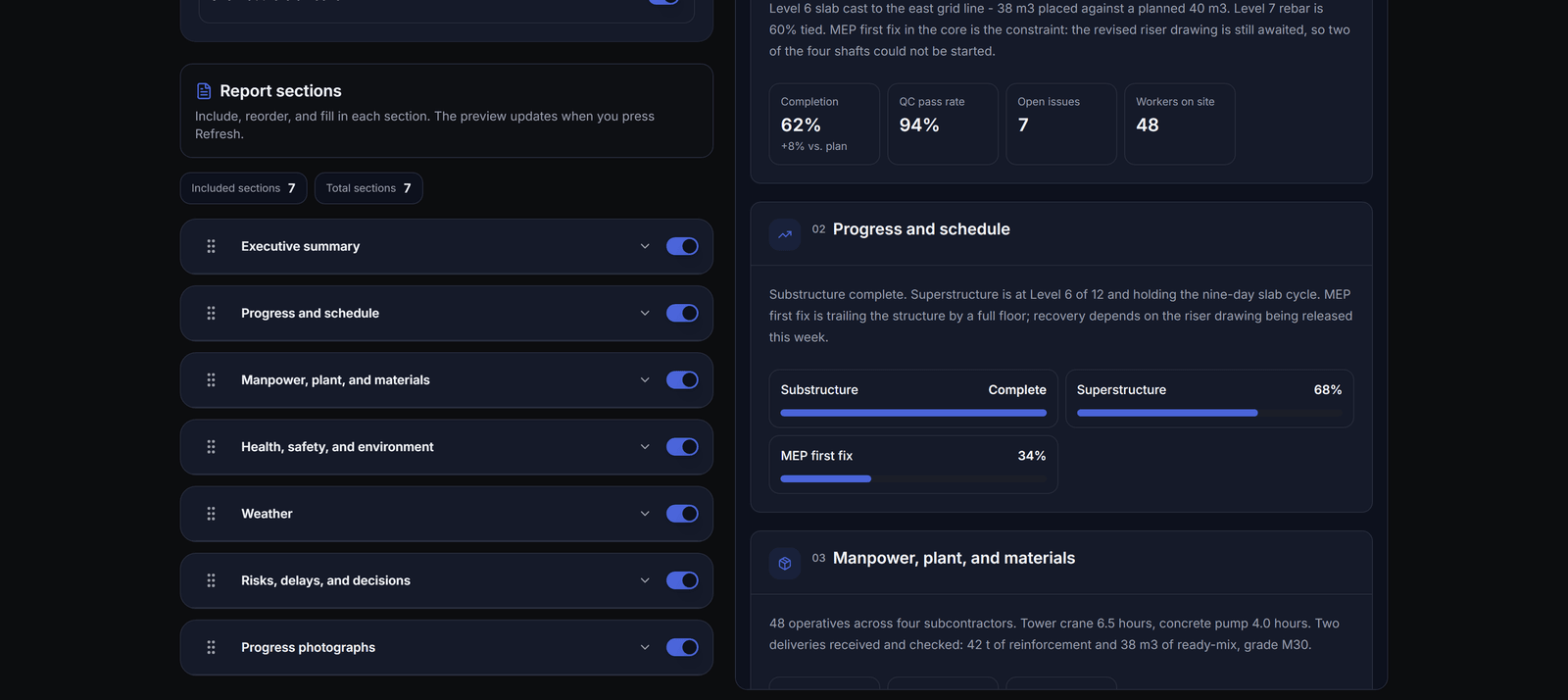

Yes — we built one, and it needs no account. The PleoStack report builder runs entirely in your browser: pick Daily from the report type selector, and it loads a daily skeleton — executive summary, progress, manpower and plant, safety, weather, delays, and photographs — instead of a blank page.

The short version of how to use it:
- Set the report type to Daily first — switching later replaces the sections.
- Fill in Cover and branding: company, client, project name and code. The code is what makes the report filable a year from now.
- Work down the sections. Each has a narrative plus structured fields — write what changed and why in the narrative, and put the quantities in the fields.
- Turn off the sections that do not apply today. An empty weather block teaches reviewers to skim.
- Press Refresh above the preview, then read it top to bottom as your client would.
- Download PDF for anything commercially sensitive, or Generate link for a read-only page — public to anyone holding it, and deleted after 14 days.
Your draft autosaves to that browser only and nothing is uploaded while you work, so finish and export in one sitting rather than treating it as storage.
The full walkthrough, with a screenshot of every step, is in how to create a construction progress report for free.
From ritual to system
The fix isn't discipline — it's removing friction. When the daily report is a structured form that pulls activities from the live WBS, counts manpower per subcontractor, and attaches geotagged photos from the field, the report writes itself as the day happens.

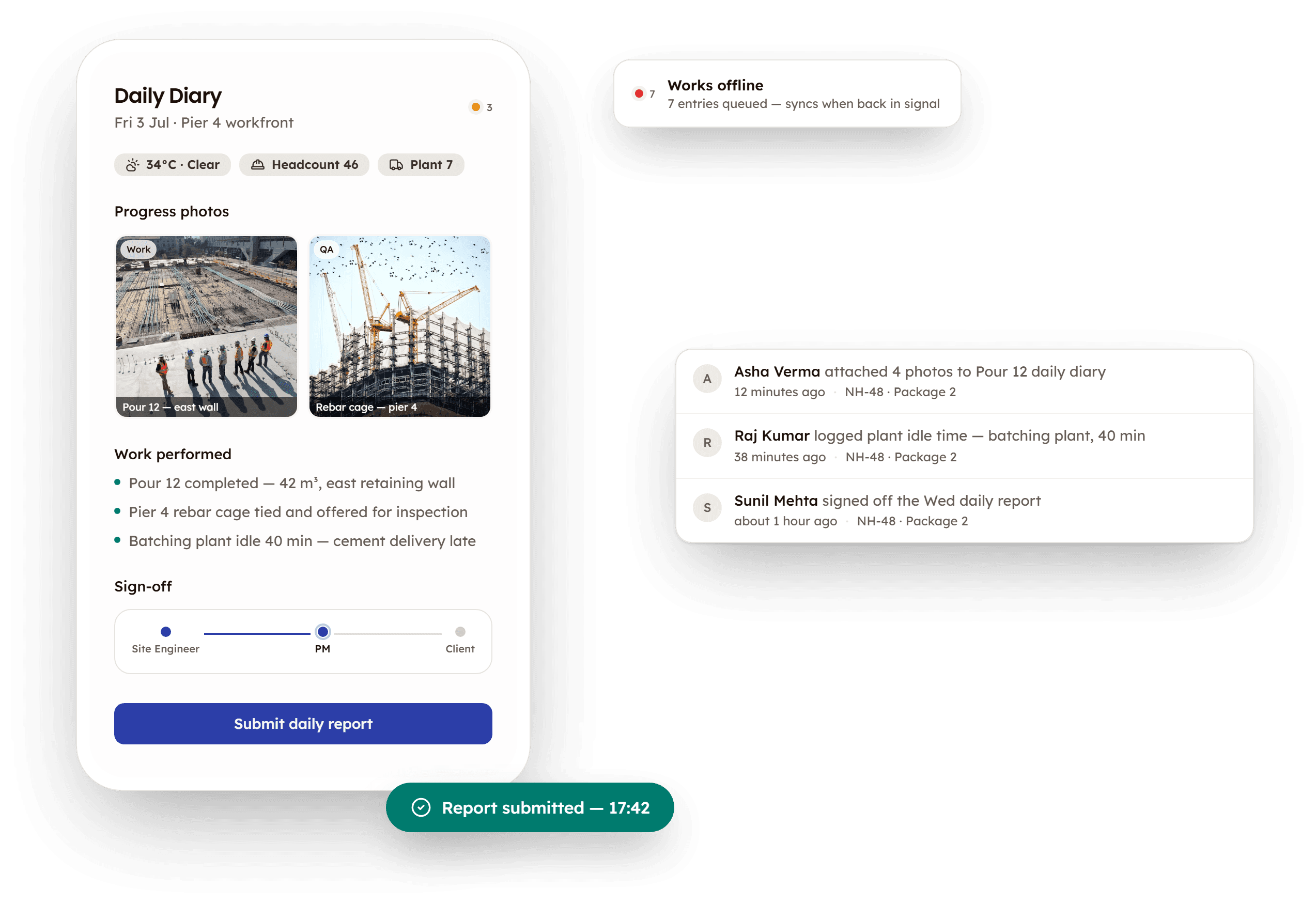

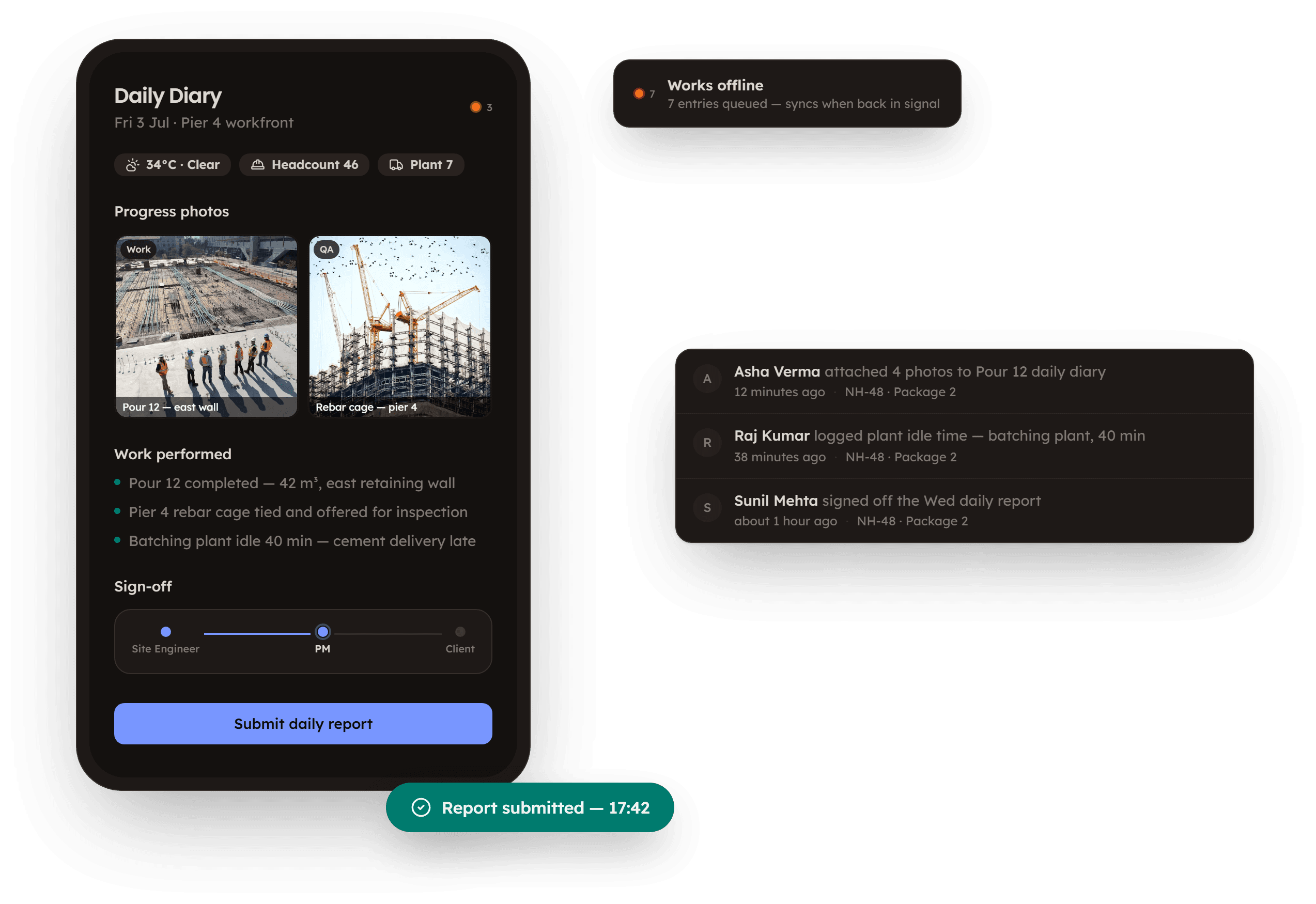

That's exactly how the Daily Reports module in the PleoStack Construction Hub works: site engineers log progress against activities from a phone — offline if needed — and the PM gets a consolidated, signable report without chasing anyone at 7 PM.
However you produce it, hold the report to one test: could someone who wasn't on site reconstruct the day from it? If yes, you have a record. If no, you have paperwork.
Adjacent entries
· Guides
How to Create a Construction Progress Report for Free (Step by Step)
Praful Rudra · 7 min read


· Industry Insights
Why Construction Teams Outgrow Spreadsheets (and What Breaks First)
Praful Rudra · 5 min read

· Company News
Why We Built PleoStack: Software Shaped to How Industries Actually Run
Praful Rudra · 5 min read
