Creating Inspections
Step-by-step guide through the 3-step creation wizard — source selection, details & scope, and party assignments.
Creating an inspection is a 3-step wizard that takes you from choosing a template to assigning parties. The inspection is ready to execute immediately after creation.
Step 1 — Choose Source
Select what checklist(s) the inspection will use:
| Source Type | When to Use |
|---|---|
| From Collection | Multi-part inspections — a collection groups related checklists (e.g., "Concrete Pre-Pour" includes Reinforcement + Formwork + Safety) |
| From Checklist | Single-focus inspections — one specific checklist for a targeted check |
Individual checklists carry a category badge — Concrete, Steel, MEP, Safety or Closeout for the ones the app labels, and whatever was typed for anything else.

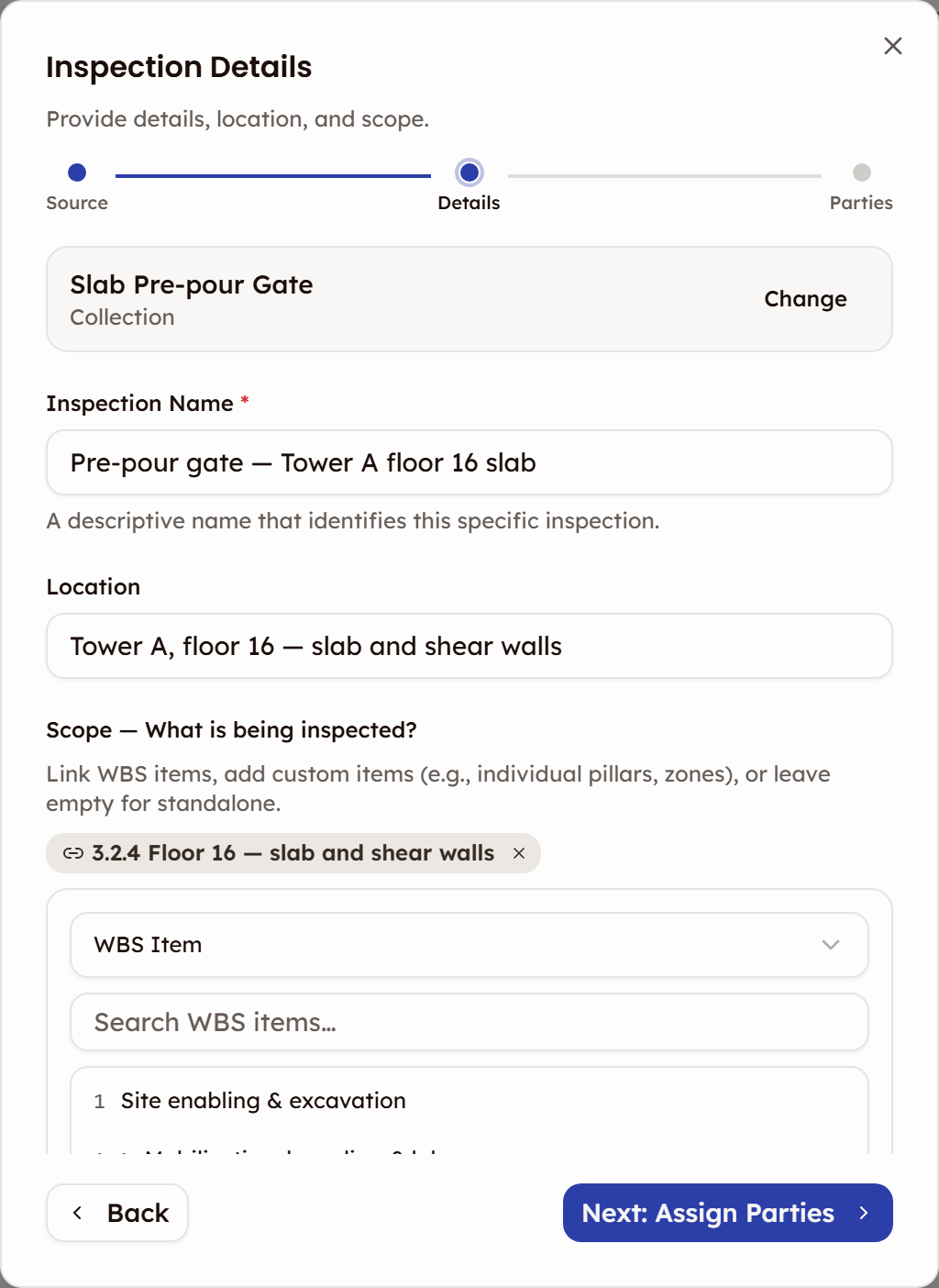

Step 2 — Details & Scope
Configure what's being inspected:
| Field | Required | Description |
|---|---|---|
| Name | Yes | Type a name — the step will not advance without one. |
| Location | No | Free text for site location (e.g., "Tower A, Level 3, Column Grid B2-B5") |
| Scope | No | Add one or more WBS Items, or a Custom Item — a label such as a pillar or zone, with an optional location. Leave it empty for a standalone inspection. Starting from a WBS item's page in the WBS fills in the scope and the name for you. |
Step 3 — Party Assignments
Name who inspects and, on quality-critical work, who approves:
| Role | Who | What They Do |
|---|---|---|
| Performer (first row) | The inspector | Records Pass/Fail/NA verdicts on each item. On a routine checklist, this closes the inspection |
| Approver (last row) | The approver, on a quality-critical checklist | Judges every item, then approves it or sends it back. Their role must hold the approve permission for inspections |
| Checker (any row in between) | Another party | Can view the inspection and takes no turn |
A quality-critical checklist (by default concrete, structural, steel, reinforcement, formwork, masonry, waterproofing, foundation and piling) needs at least two parties, and the last must hold the approve permission for inspections. The step says so before you press Create Inspection.
All Roles Required
All party slots must have a team member assigned before the inspection can be created — there is no way to fill them in later. Each party must also be a different person.
Single-party mode: On a routine checklist, if only one person is handling the inspection, remove the Checker and Approver rows so a single party remains, then assign that person. The inspection is then created as single-party, with one Complete Inspection step. Assigning the same person to more than one party is rejected.
After Creation
The inspection appears in the hub as Not Started. The Performer can click it to open the detail page and begin recording verdicts.
Next Steps
- Execution Overview — What the detail page looks like and how to record verdicts
- Who Signs an Inspection — The inspector, and an approver on quality-critical work
Questions
Can I add or remove checklist items once the inspection is created?
No. The inspection takes a copy of the checklist items when you create it. To change what gets checked, edit the template and create a new inspection from it.
If someone edits the template later, does my inspection change?
No. Your inspection keeps the items it was created with. Later edits only reach inspections created after them.
Why can’t I press Create Inspection?
A party slot is empty, the same person is in two slots, or a quality-critical checklist has no approver who holds the approve permission. The message under the parties says which. Each party must be a different person. For a solo inspection on a routine checklist, remove the Checker and Approver rows instead.
